Dry Volume of Concrete Why Most Get the 1.54 Factor Wrong

Dry volume of concrete = wet volume × 1.54.

You need this extra volume of loose cement, sand and aggregate because dry particles have air gaps that disappear once water is added and the mix is compacted. Skip the factor and you will short every material by roughly one-third.

Most beginners measure the finished size of a slab or column and stop there. That finished size is the wet volume. The dry ingredients must be ordered in a larger quantity so that, after voids collapse, you still fill the formwork completely.

What Is Dry Volume of Concrete ?

Dry volume is the total bulk volume of cement + sand + coarse aggregate measured in their loose, unmixed state.

Wet volume is the actual space the concrete will occupy after mixing, placing and compaction the volume of the shuttering or the finished structural element.

When water is added, cement paste and fine particles slide into the air pockets between the larger stones and sand grains. The mixture becomes denser and occupies less space. To end up with 1 m³ of finished concrete you therefore start with about 1.54 m³ of dry materials.

Why the Factor Is 1.54 (Not 1.5 or 1.6)

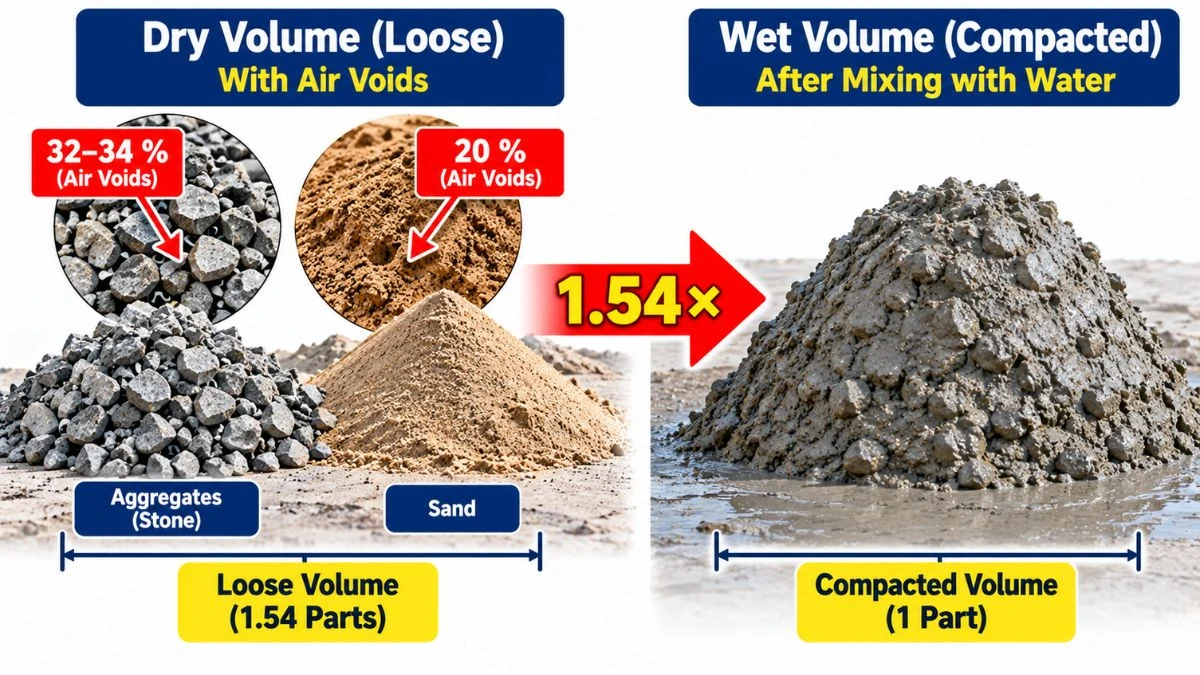

Diagram showing why dry volume of concrete is 1.54 times wet volume due to aggregate voids

The number comes from typical void ratios found in normal concrete aggregates:

  • Coarse aggregate (20 mm) contains roughly 32–34 % voids
  • Fine aggregate (sand) contains roughly 20 % voids

Adding these percentages gives 52–54 %. Engineers round the combined allowance to 54 %, so the conversion factor becomes 1.54.

In practice the factor sits between 1.52 and 1.57 depending on aggregate shape and grading. Across India the industry standard for nominal-mix estimation is 1.54. Design-mix concrete (M25 and above) uses laboratory batch weights and does not rely on this volume factor.

Dry Volume Formula

Dry Volume = Wet Volume × 1.54

That is the only formula you need for ordinary volume-batched concrete.

Step-by-Step Calculation

  1. Measure or calculate the wet volume from drawings (Length × Width × Depth).
  2. Multiply by 1.54 to obtain dry volume.
  3. Divide the dry volume by the sum of the mix-ratio parts.
  4. Multiply each part by the dry volume share to get individual material volumes.
  5. Convert cement volume into bags (density 1440 kg/m³, one bag = 50 kg).

Comparison Table Dry Volume Factors

Comparison chart of dry volume factors for concrete, mortar and plaster

Material / Application Typical Factor Reason
Nominal-mix concrete 1.54 Voids in coarse + fine aggregate
Cement mortar 1.33 Only sand voids + small wastage
Plaster 1.27–1.33 + 20 % surface Sand voids + uneven wall surface
Design-mix concrete Not used Materials given by weight per m³

Use the correct factor for the material you are estimating. Applying the concrete factor to mortar over-orders cement and sand.

Worked Example 1 – Floor Slab

Worked example table dry volume calculation for concrete floor slab using 1.54 factor

Given

  • Slab size: 5 m × 4 m × 0.15 m thick
  • Mix: M20 (1 : 1.5 : 3)

Step 1 – Wet volume
5 × 4 × 0.15 = 3.0 m³

Step 2 – Dry volume
3.0 × 1.54 = 4.62 m³

Step 3 – Sum of parts
1 + 1.5 + 3 = 5.5

Step 4 – Material volumes

  • Cement = (1 / 5.5) × 4.62 = 0.840 m³
  • Sand = (1.5 / 5.5) × 4.62 = 1.260 m³
  • Aggregate = (3 / 5.5) × 4.62 = 2.520 m³

Step 5 – Cement bags
0.840 × 1440 = 1209.6 kg
1209.6 ÷ 50 = 24.19 → order 25 bags

Worked Example 2 – Column (Different Scenario)

Given

  • Column size: 0.3 m × 0.45 m × 3.2 m high
  • Number of columns: 4
  • Mix: M25 nominal (1 : 1 : 2) for illustration

Step 1 – Wet volume of one column
0.3 × 0.45 × 3.2 = 0.432 m³
Four columns = 1.728 m³

Step 2 – Dry volume
1.728 × 1.54 = 2.661 m³

Step 3 – Sum of parts
1 + 1 + 2 = 4

Step 4 – Material volumes

  • Cement = (1 / 4) × 2.661 = 0.665 m³
  • Sand = (1 / 4) × 2.661 = 0.665 m³
  • Aggregate = (2 / 4) × 2.661 = 1.331 m³

Step 5 – Cement bags
0.665 × 1440 = 957.6 kg
957.6 ÷ 50 = 19.15 → order 20 bags

These two examples show the same 1.54 factor applied to completely different members a horizontal slab and vertical columns.

How to Convert Wet Volume to Dry Volume on Site

  1. Calculate the geometric volume from the latest drawings.
  2. Add any over-excavation or formwork deflection if known (usually 2–5 %).
  3. Multiply the adjusted wet volume by 1.54.
  4. Split by the mix ratio.
  5. Round cement bags upward and keep a small contingency for spillage.

Never apply the 1.54 factor on top of ready mix bag yields. Ready mix already accounts for the finished volume.

Common Mistakes Beginners Make

  • Using wet volume directly for material purchase.
  • Applying 1.54 to mortar or plaster.
  • Forgetting to convert cement volume into bags.
  • Ignoring moisture in sand (bulking).
  • Using the factor on design-mix concrete that is already specified by weight.
  • Rounding down instead of up on cement bags.

Any of these errors leads to either shortage on the pour day or expensive leftover material.

Practical Tips from Site Experience

Keep a simple notebook with the 1.54 conversion written on the first page. When the site supervisor calls for “three cubes of M20”, you already know the dry quantities.

Measure aggregates by volume boxes of known size rather than by eye. Consistent box size removes another source of error.

For small residential jobs a 5 % extra allowance on top of the 1.54 calculation is usually enough. For large continuous pours keep the factor pure and order a standby transit mixer if needed.

Relation to Indian Standards

IS 456:2000 (Plain and Reinforced Concrete Code of Practice) governs grades, durability and workmanship. It does not prescribe the 1.54 factor; that factor is a long-established site estimation practice used with nominal mixes permitted under the code for grades up to M20.

CPWD Specifications also follow the same volume-to-dry conversion method for quantity estimation of nominal concrete. Always cross check the latest drawing notes and structural engineer’s mix designation before ordering.

Quick Reference Summary

  • Dry volume = wet volume × 1.54 for concrete
  • Dry volume = wet volume × 1.33 for mortar
  • Always calculate wet volume first from dimensions
  • Split dry volume by the mix-ratio sum
  • Convert cement to bags using 1440 kg/m³
  • Order slightly more than the calculated bags

Master this single conversion and material estimation becomes reliable even for first-time builders.

Frequently Asked Questions

Dry volume of concrete is the volume of loose cement, sand and aggregate required before water is added. It is calculated as wet volume × 1.54.

Dry aggregates contain air voids (about 32–34 % in coarse aggregate and 20 % in sand). These voids total roughly 54 %, so the dry materials occupy 1.54 times the final compacted volume.

Dry volume = 1 × 1.54 = 1.54 m³. Then divide 1.54 by the sum of the mix-ratio parts to get individual quantities.

No. Mortar uses 1.33 (or sometimes 1.27) because it has no coarse aggregate and therefore fewer voids.

No. Design mixes give material quantities by weight per cubic metre of finished concrete. The 1.54 factor is only for nominal volume-batched mixes.

Dry volume = 1.54 m³. Cement volume = 1.54 × (1/5.5) = 0.28 m³. Weight = 0.28 × 1440 = 403 kg ≈ 8.06 bags. Order 9 bags.
