How to Calculate Construction Site Capacity Avoid 90% Errors
This beginner-friendly guide explains how to calculate construction site capacity using four limits: labour, equipment, material and space. It gives a simple formula and two worked examples (slab concreting and plastering). It also covers cement storage rules from IS 4082 and the mistakes that make site plans fail.
To calculate construction site capacity, work out the daily output of your labour, equipment, materials and working space separately, then take the lowest of the four. That lowest number is your real site capacity, because the slowest resource sets the pace for the whole site.
Most beginners count workers and stop there. That gives a number that looks good on paper and falls apart by 11 am. If you’re learning how to calculate construction site capacity, this guide gives you a simple method, two worked examples with real numbers, and the mistakes to avoid.

What Is Construction Site Capacity ?
Construction site capacity is the most work your site can finish in a set time, usually one day. You measure it in the unit of the work itself: m³ of concrete per day, m² of plaster per day, or bricks laid per day.
Capacity is different from your target. The target is what you want to finish. Capacity is what the site can deliver today, with the people, machines, materials and space you actually have.
When the target is bigger than capacity, the job runs late, workers sit idle, or quality drops. Knowing your capacity before you start tells you how many days a task really needs and which problem to fix first.
The 4 Limits That Decide Your Site Capacity

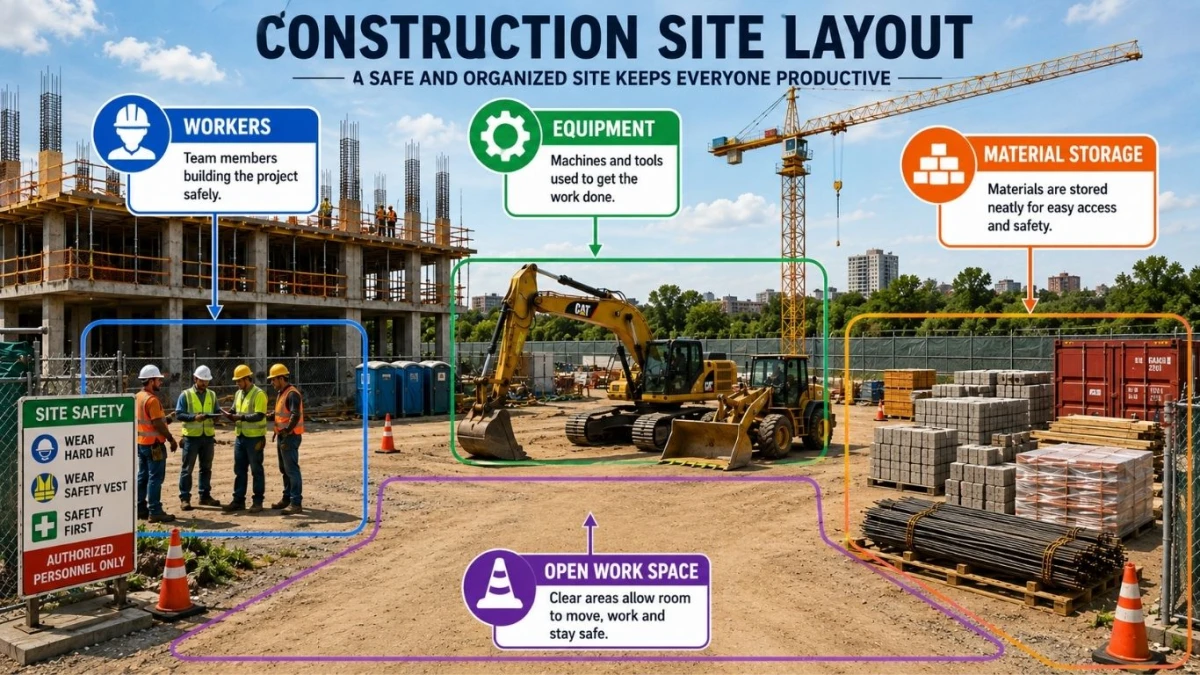

Every activity on site depends on four things. Each one has its own ceiling, and you need to check all four.
1. Labour Capacity
This is how much work your crew can finish in a day. It depends on the number of workers, their skill and the output each worker delivers. Ten skilled masons will always out-lay ten beginners.
2. Equipment Capacity
This is how much work your machines can handle. A concrete mixer, hoist or vibrator has a rated output. That output drops when the machine waits for material or breaks down.
3. Material Capacity
This is how much work your available material can support. If 80 bags of cement are on site, you can use 80 bags, however many workers stand around. Delivery timing and safe storage both count here.
4. Space Capacity
This is how many workers and machines can work safely at the same time. A small room, a crowded staircase or a half-cleared floor caps the number of people who can work at once.
Here’s how the four limits compare side by side
| Limit | What it tells you | Simple formula | Typical unit |
|---|---|---|---|
| Labour | Work the crew can finish | Workers × output per worker × efficiency factor | m³, m² or nos per day |
| Equipment | Work the machines can handle | Machines × output per machine per hour × hours × efficiency factor | m³ per day |
| Material | Work the available stock supports | Material available ÷ material needed per unit of work | m³ or m² per day |
| Space | Work that fits in the area | Workers who fit × output per worker × efficiency factor | m³ or m² per day |
The Basic Formula for Construction Site Capacity
Use this for labour and equipment:
Capacity per day = Number of workers (or machines) × Output per worker (or machine) per day × Efficiency factor
Then pick the winner:
Site Capacity = the lowest of Labour, Equipment, Material and Space capacity
The efficiency factor covers real life: tea breaks, waiting for material, rain, rework and shifting scaffolding. It’s a decimal below 1. Many planners start between 0.7 and 0.9 and adjust from their own site records. The examples below use 0.8.
Where do you get the output per worker? Labour output constants for building work are given in IS 7272 (Part 1), and CPWD’s Analysis of Rates is another common reference. Your own past site records are better still. The output figures in this article are assumed to keep the maths clear, so swap in your own numbers.
How to Calculate Construction Site Capacity Step by Step
Follow these six steps for any activity on your site.
- Pick one activity and one unit. For example, slab concreting in m³ per day. Don’t mix activities in one calculation.
- List what the activity needs. Workers, machines, materials and working area.
- Find the output of each. Output per worker per day, output per machine per hour, and material needed per unit of work.
- Choose an efficiency factor. 0.8 is a sensible starting point for beginners.
- Calculate the four limits. Use the formulas from the table above.
- Take the lowest and compare it with your target. Days needed = Target quantity ÷ Site capacity.
Run the steps again after every change on site. The bottleneck moves, and you’ll see exactly how in the examples below.
Material Limit How Many Cement Bags Can Your Site Store ?

Material is the limit beginners forget. Start with cement, because it spoils.
IS 4082:1996, the Indian Standard for stacking and storage of construction materials at site, recommends stacking cement bags no more than 10 high and keeping the stack at least 600 mm away from external walls. Keep the bags on a raised platform in a dry, covered store. For planning, assume one bag takes about 0.3 m² of floor space.
Here’s how to find your store’s capacity:
- Subtract 1.2 m from the store’s length and width (600 mm clearance on each side).
- Multiply the two reduced sides to get the usable area.
- Divide by 0.3 and round down to get bags per layer.
- Multiply by 10 layers.
| Store size | Usable area | Bags per layer | Total bags (10 high) | M20 concrete supported (8 bags per m³) |
|---|---|---|---|---|
| 3 m × 3 m | 3.24 m² | 10 | 100 | 12.5 m³ |
| 4 m × 3 m | 5.04 m² | 16 | 160 | 20 m³ |
| 5 m × 4 m | 10.64 m² | 35 | 350 | 43.75 m³ |
M20 (1:1.5:3) uses about 8 bags of cement per m³ of concrete, based on the 1.54 dry volume factor. M20 is also the minimum grade for reinforced concrete in mild exposure under IS 456:2000.
These counts are maximums. A real store needs a walking gap, so your practical number will be lower.
Worked Example 1 Slab Concreting Capacity

Scenario: You’re casting a 100 m² roof slab, 150 mm thick, in M20 concrete. The volume is 100 × 0.15 = 15 m³. The goal is to finish in one 8-hour day.
Assumed inputs:
- Crew of 12 workers, each placing about 1.5 m³ per day
- One half-bag mixer giving 0.2 m³ per batch, 8 batches per hour
- A full 4 m × 3 m cement store (160 bags), with M20 needing 8 bags per m³
- Each worker needs about 4 m² of working area on the slab
- Efficiency factor of 0.8
Calculations:
- Labour = 12 × 1.5 × 0.8 = 14.4 m³ per day
- Equipment = 0.2 × 8 batches × 8 hours × 0.8 = 10.24 m³ per day
- Material = 160 ÷ 8 = 20 m³ per day
- Space = 100 ÷ 4 = 25 workers fit, so 25 × 1.5 × 0.8 = 30 m³ per day

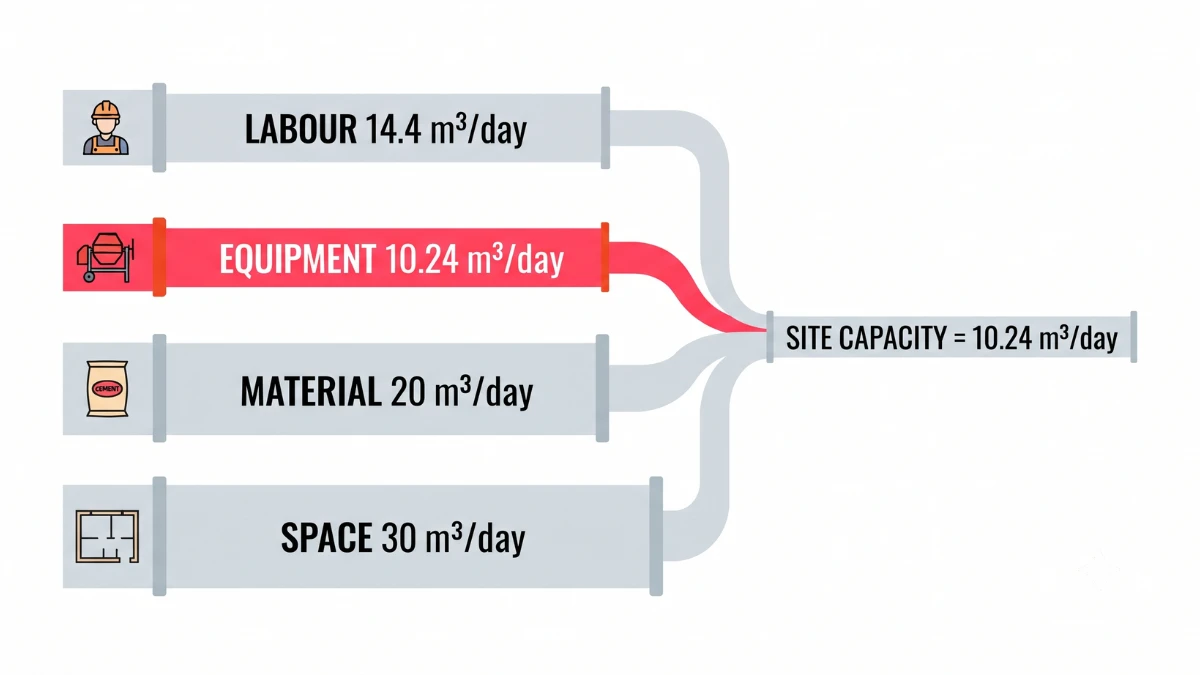

The lowest number is the mixer at 10.24 m³ per day. Your crew could place 14.4 m³, but the mixer can’t feed them fast enough. The 15 m³ slab needs 15 ÷ 10.24 = 1.46 days, which means a pour that stops midway and leaves a construction joint. IS 456 gives guidance on where those joints can go, but it’s better to plan the pour so it doesn’t stop.
Now watch the bottleneck move as you fix the problem:

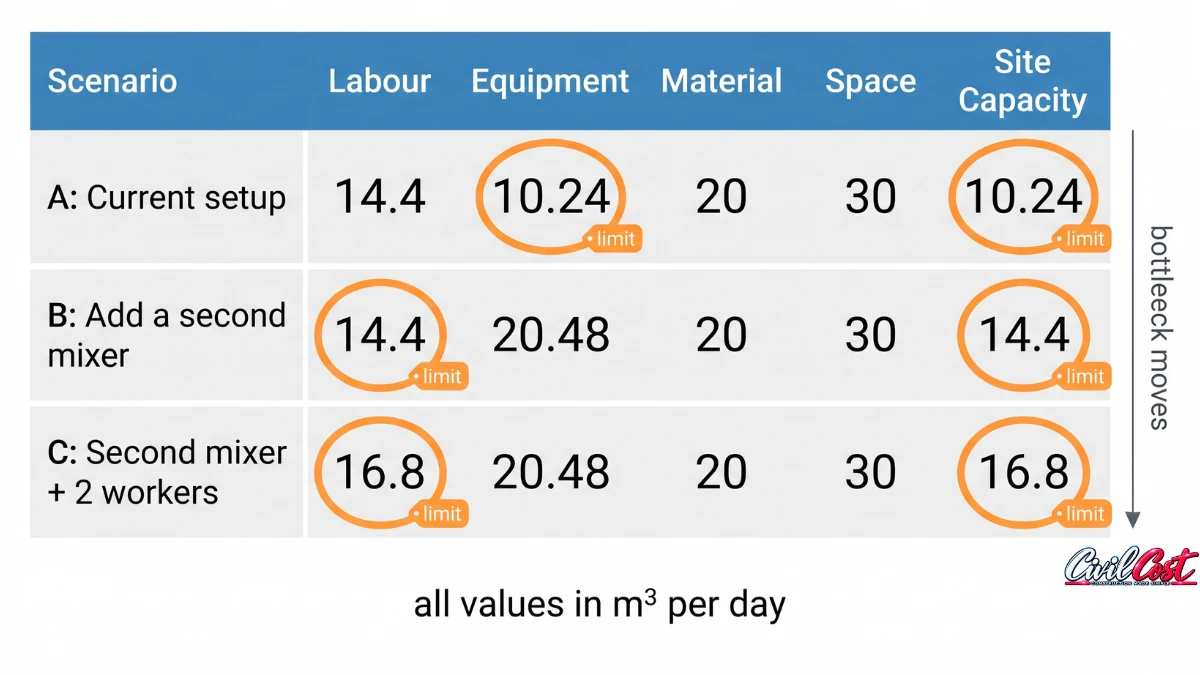

| Scenario | Labour | Equipment | Material | Space | Site capacity | Limiting factor |
|---|---|---|---|---|---|---|
| A: Current setup | 14.4 | 10.24 | 20 | 30 | 10.24 | Equipment |
| B: Add a second mixer | 14.4 | 20.48 | 20 | 30 | 14.4 | Labour |
| C: Second mixer + 2 more workers (14) | 16.8 | 20.48 | 20 | 30 | 16.8 | Labour |
All values are in m³ per day. In scenario C, capacity is 16.8 m³ per day, which beats the 15 m³ target. The slab can be cast in one day.
Worked Example 2 Plastering Capacity on One Floor

A second scenario shows the same formula working on finishing work, where a different limit takes over.
Scenario: You’re plastering the internal walls of one floor, 12 mm thick, in 1:6 cement mortar. Your target is 60 m² per day.
Assumed inputs:
- 8 plasterers, each finishing 10 m² per day
- 3 of the 6 rooms are ready (conduits done, scaffolding in place), and each ready room fits 2 plasterers
- 5 bags of cement on site for the day, with plaster needing about 0.08 bag per m² (roughly 4 kg including wastage)
- Hand mixing and ready scaffolding, so equipment isn’t a limit
- Efficiency factor of 0.8
Calculations:
- Labour = 8 × 10 × 0.8 = 64 m² per day
- Space = 3 rooms × 2 plasterers = 6 plasterers fit, so 6 × 10 × 0.8 = 48 m² per day
- Material = 5 ÷ 0.08 = 62.5 m² per day

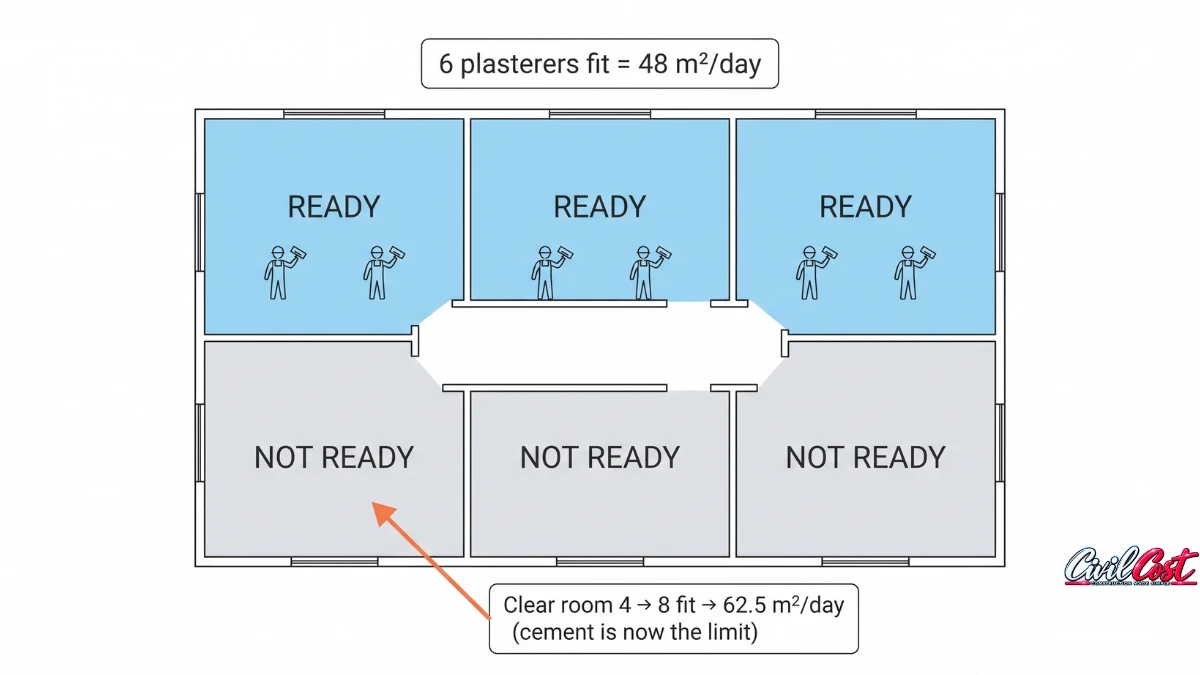

The lowest number is space at 48 m² per day. That’s below your 60 m² target, and two plasterers have nowhere to work.
The fix: Clear a fourth room. Now 4 rooms × 2 = 8 plasterers fit, so space rises to 64 m² per day. The new lowest number is material at 62.5 m² per day, which beats the 60 m² target. Cement supply is now the limit, so ordering one more bag before the shift gives you a safety margin.
In Example 1 the machine was the bottleneck. Here it was space. The method didn’t change, only the answer did.
How to Increase Construction Site Capacity
Always fix the lowest limit first. Raising any other number changes nothing.
- Equipment: Add a machine, or keep the existing one fed so it never waits.
- Labour: Add workers only when the other three limits can carry them. A clear gang structure and better training also raise output per worker.
- Material: Stock up before the pour or shift. Order deliveries a day early and build your store to the IS 4082 rules.
- Space: Sequence trades so rooms are clean and free. Stage materials close to the work and clear debris daily.
Recalculate after each change. The new lowest limit is your next job.
Common Mistakes When Calculating Site Capacity
- Counting only workers. This is the biggest one. Labour is one limit out of four.
- Using 100% efficiency. No site works at full output for eight straight hours.
- Copying output figures blindly. Book values help, but check them against your site conditions and crew.
- Forgetting delivery gaps. Material that arrives at 2 pm can’t support a 9 am pour.
- Ignoring space. More workers in the same room lowers output per person.
- Mixing units. Keep m³, m² and nos separate for each activity.
- Calculating once and never updating. Capacity changes whenever the crew, machine or stock changes.
Safety Check Before You Push Capacity
A higher capacity number never justifies unsafe crowding. The National Building Code of India 2016, Part 7 (Construction Management, Practices and Safety), covers site practices and safety. IS 7969:1975 is the safety code for handling and storage of building materials. If your space calculation forces workers shoulder to shoulder, reduce the crew instead of the safety margin.
Final Thoughts How to Calculate Construction Site Capacity the Right Way
Now you know how to calculate construction site capacity without guessing. Work out labour, equipment, material and space on their own, apply a realistic efficiency factor, and take the lowest result. That one number tells you how many days the work needs and what to fix first. Run the calculation before each major activity, and keep your own output records so the next one is even more accurate.
